fidic施工合同条件中英文

合集下载

fidic合同中英文对照

fidic合同中英文对照

Fidic合同是指国际咨询工程师联合会(Fédération Internationale des Ingénieurs Conseils,简称FIDIC)制定的一系列国际工程合同标准。

以下是FIDIC合同中英文对照的一些常见术语:1. 业主(Employer):甲方2. 承包商(Contractor):乙方3. 工程师(Engineer):监理单位4. 合同价格(Contract Price):合同总价5. 合同期限(Contract Time):工期6. 质量保证(Quality Assurance):质量保证期7. 付款方式(Payment Method):支付方式8. 变更指令(Variation Order):变更通知9. 索赔(Claim):索赔申请10. 延期(Delay):延期申请11. 分包(Subcontracting):分包合同12. 竣工验收(Completion and Acceptance):竣工验收13. 保留金(Retention Money):保证金14. 违约金(Penalty):违约金15. 争议解决(Dispute Resolution):争议解决方式16. 保险(Insurance):保险责任17. 环境保护(Environmental Protection):环境保护责任18. 安全生产(Safety Production):安全生产责任19. 劳动权益(Labor Rights and Interests):劳动权益保障20. 信息交流(Information Exchange):信息交流和沟通以上仅为FIDIC合同中部分常见术语的中英文对照,实际应用时还需根据具体合同条款进行理解和翻译。

FIDIC金皮书中英文(设计施工和营运合同条件)第3部分

FIDIC金皮书中英文(设计施工和营运合同条件)第3部分

FIDIC⾦⽪书中英⽂(设计施⼯和营运合同条件)第3部分5 Design设计5.1General Design Obligations 设计义务的⼀般要求The Contractor shall carry out, and be responsible for, the design of the Works. Design shall be prepared by qualified designers who are engineers or other professionals who comply with the criteria (if any) stated in the Employer’s Requirements. Unless otherwise stated in the Contract, the Contractor shall submit to the Employer’s Representative for consent the name and particulars of each proposed design and design subcontractor.承包商应进⾏并负责⼯程的设计。

设计应由合格的设计⼈员进⾏,此类设计⼈员应为符合业主要求中规定的标准(如有时)的⼯程师或其他专业⼈员。

除⾮合同中另有规定,否则,承包商应向业主代表提交每位拟雇⽤的设计⼈员和设计分包商的姓名及详细情况,以供其批准。

The Contractor warrants that he, his designers and design Subcontractors have the experience and capability necessary for the design. The Contractor undertakes that the designers shall be available to attend discussions with the Employer’s Representative at all reasonable times.承包商应担保其⾃⼰、其设计⼈员和设计分包商具备从事设计所必须的经验和能⼒。

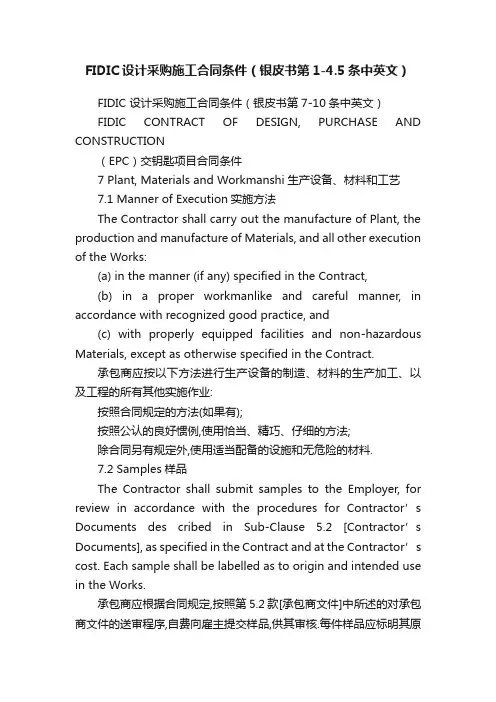

FIDIC设计采购施工合同条件(银皮书第1-4.5条中英文)

FIDIC设计采购施工合同条件(银皮书第1-4.5条中英文)

FIDIC设计采购施工合同条件(银皮书第1-4.5条中英文)FIDIC 设计采购施工合同条件(银皮书第7-10条中英文)FIDIC CONTRACT OF DESIGN, PURCHASE AND CONSTRUCTION(EPC)交钥匙项目合同条件7 Plant, Materials and Workmanshi生产设备、材料和工艺7.1 Manner of Execution实施方法The Contractor shall carry out the manufacture of Plant, the production and manufacture of Materials, and all other execution of the Works:(a) in the manner (if any) specified in the Contract,(b) in a proper workmanlike and careful manner, in accordance with recognized good practice, and(c) with properly equipped facilities and non-hazardous Materials, except as otherwise specified in the Contract.承包商应按以下方法进行生产设备的制造、材料的生产加工、以及工程的所有其他实施作业:按照合同规定的方法(如果有);按照公认的良好惯例,使用恰当、精巧、仔细的方法;除合同另有规定外,使用适当配备的设施和无危险的材料.7.2 Samples样品The Contractor shall submit samples to the Employer, for review in accordance with the procedures for Contractor’s Documents des cribed in Sub-Clause 5.2 [Contractor’s Documents], as specified in the Contract and at the Co ntractor’s cost. Each sample shall be labelled as to origin and intended use in the Works.承包商应根据合同规定,按照第5.2款[承包商文件]中所述的对承包商文件的送审程序,自费向雇主提交样品,供其审核.每件样品应标明其原产地、及其在工程中预期的用处.7.3 Inspection检验The Employer’s Personnel shall at all reasonable times:(a) have full access to all parts of the Site and to all places from which natural Materials are being obtained, and(b) during production, manufacture and construction (at the Site and, to the extent specified in the Contract, elsewhere), be entitled to examine, inspect, measure and test the materials and workmanship, and to check the progress of manufacture of Plant and production andmanufacture of Materials.雇主人员应在所有合理的时间内:有充分机会进入现场的所有部分、以及获得天然材料的所有地点;有权在加工、生产和施工期间(在现场和其他合同规定的范围),对材料和工艺进行检查、检验、测量和试验,并对生产设备的制造和材料的加工生产进度进行检查.The Contractor shall give the Employer’s Personnel full opportunity to carry out these activities, including providing access, facilities, permissions and safety equipment. No such activity shall relieve the Contractor from any obligation or responsibility.承包商应向雇主人员进行上述活动提供一切机会,包括提供进入条件、设施、许可和安全装备.此类活动不应解除承包商的任何义务和职责.In respect of the work which Employer’s Personnel are entitled to examine, inspect, measure and/or test, the Contractor shall give notice to the Employer whenever any such work is ready and before it is covered up, put out of sight, or packaged for storage or transport. The Employer shall then either carry out the examination, inspection, measurement or testing withoutunreasonable delay, or promptly give notice to the Contractor that the Employer does not require to do so. If the Contractor fails to give the notice, he shall, if and when required by the Employer, uncover the work and thereafter reinstate and make good, all at the Contractor’s cost.对于雇主人员有权检查、检验、测量和(或)试验的工作,每当任何此类工作已经准备好,在覆盖、掩蔽、包装以便储存或运输前,承包商应通知雇主.这时,雇主应及时进行检查、检验、测量和试验,不得无故拖延,或者立即通知承包商无需进行这些工作.如果承包商没有发出此类通知,而当雇主提出要求时,承包商应除去物件上的覆盖,并在随后恢复完好,所需费用由承包商承担.7.4 Testing试验This Sub-Clause shall apply to all tests specified in the Contract, other than the Tests after Completion (if any).本款适用于竣工后试验(如果有)以外的合同规定的所有试验.The Contractor shall provide all apparatus, assistance, documents and other information, electricity, equipment, fuel, consumables, instruments, labor, materials, and suitably qualified and experienced staff, as are necessary to carry out the specified tests efficiently. The Contractor shall agree, with the Employer, the time and place for the specified testing of any Plant, Materials and other parts of the Works.为有效进行规定的试验,承包商应提供所需的所有仪器、帮助、文件和其他资料、电力、装备、燃料、消耗品、工具、劳力、材料,以及具有适当资质和经验的人员,对任何生产设备、材料和工程其他部分进行规定的试验,其时间和地点,应由承包商和雇主商定.The Employer may, under Clause 13 [Variations and Adjustments], vary the location or details of specified tests, or instruct the Contractor to carry out additional tests. If thesevaried or additional tests show that the tested Plant, Materials or workmanship is not in accordance with the Contract, the cost of carrying out this Variation shall be borne by the Contractor, notwithstanding other provisions of the Contract.根据第13条[变更和调整]的规定,雇主可以改变进行规定试验的位置或细节,或指示承包商进行附加的试验.如果这些变更或附加的试验表明,经过试验的生产设备、材料、或工艺不符合合同的要求,不管合同有何其他规定,承包商应负担进行本项变更的费用.The Employer shall give the Contractor not less than 24 hours’ notice of the Employer’s intention to attend the tests. If the Employer does not attend at the time and place agreed, the Contractor may proceed with the tests, unless otherwise instructed by the Employer, and the tests shall then be deemed to have been made in the Employer’s presence.雇主应至少提前24小时将参加试验的意图通知承包商.如果雇主没有在商定的时间和地点参加试验,除非雇主另有指示,承包商可以自行进行试验,这些试验应被视为是在雇主在场情况下进行的.If the Contractor suffers delay and/or incurs Cost from complying with these instructions or as a result of a delay for which the Employer is responsible, the Contractor shall give notice to the Employer and shall be entitled subject to Sub-Clause 20.1 [Contractor’s Claims] to:如果由于服从这些指示,或因雇主应负责的延误的结果,使承包商遭受延误和(或)招致费用,承包商应向雇主发出通知,并有权根据第20.1款[承包商的索赔]的规定提出:(a) an extension of time for any such delay, if completion is or will be delayed, under Sub-Clause 8.4 [Extension of Time for Completion], and根据第8.4款[竣工时间的延长]的规定,如果竣工已或将受到延误,对任何此类延误给予延长期;(b) payment of any such Cost plus reasonable profit, which shall be added to the Contract Price.任何上述费用加合理利润应加入合同价格,给予支付.After receiving this notice, the Employer shall proceed in accordance with Sub-Clause 3.5 [Determinations] to agree or determine these matters.雇主在收到此通知后,应按照第3.5款[确定]的要求对此类事项进行商定或确定.The Contractor shall promptly forward to the Employer duly certified reports of the tests. Whenthe specified test s have been passed, the Employer shall endorse the Contractor’s test certificate, or issue a certificate to him, to that effect. If the Employer has not attended the tests, he shall be deemed to have accepted the readings as accurate.承包商应立即向雇主提交充分证实的试验报告.当规定的试验通过时,雇主应在承包商的试验证书上签字认可,或向承包商颁发等效的证书.如果雇主未参加试验,他应被视为已经认可试验示数是准确的.7.5 Rejection拒收If, as a result of an examination, inspection measurement or testing, any Plant, Materials, design or workmanship is found to be defective or otherwise not in accordance with the Contract, the Employer may reject the Plant, Materials, design or workmanship by giving notice to the Contractor, with reasons. The Contractor shall then promptly make good the defect and ensure that the rejected item complies with the Contract.如果检查、检验、测量或试验结果,发现任何生产设备、材料、设计或工艺有缺陷,或不符合合同要求,雇主可通过向承包商发出通知,并说明理由,拒收该生产设备、材料、设计或工艺.承包商应立即修复缺陷,并保证上述被拒收的项目符合合同的规定.If the Employer requires this Plant, Materials, design orworkmanship to be retested, the tests shall be repeated under the same terms and conditions. If the rejection and retesting cause the Employer to incur additional costs, the Contractor shall subject to Sub-Clause 2.5 [Employer’s Claims] pay these costs to the Employer.如果雇主要求对上述生产设备、材料、设计或工艺再次进行试验,这些试验应按相同的条款和条件重新进行.如果此项拒收和再次试验使雇主增加了费用,承包商应遵照第2.5款[雇主的索赔]的规定,将该费用付给雇主.7.6 Remedial Work修补工作Notwithstanding any previous test or certification, the Employer may instruct the Contractor to:(a) remove from the Site and replace any Plant or Materials which is not in accordance with the Contract,(b) remove and re-execute any other work which is not in accordance with the Contract, and(c) execute any work which is urgently required for the safety of the Works, whether because of an accident, unforeseeable event or otherwise.尽管已有先前的任何试验或证书,雇主仍可指示承包商进行以下工作:(i) 将不符合合同要求的任何生产设备或材料移出现场,并进行更换;(ii)去除不符合合同的任何其他工作,并重新实施;(iii)实施因意外、不可预见的事件或其他原因引起的、为工程的安全迫切需要的任何工作.If the Contractor fails to comply with any such instruction, which complies with Sub-Clause 3.4 [Instructions], the Employer shall be entitled to employ and pay other persons to carry out the work. Except to the extent that the Contractor would have been entitled to payment for the work, the Contractor shallsubject to Sub-Clause 2.5 [Employer’s Claims] pay to the Employer all costs arising from this failure如果承包商未能服从任何此类符合第3.4款[指示]要求的指示,雇主应有权雇用并付款给他人从事该工作.除承包商原有权从该工作所得付款的范围外,承包商应遵照第2.5款[雇主的索赔]的规定,向雇主支付因他未履行指示而使雇主支付的所有费用.7.7 Ownership of Plant and Materials生产设备和材料的所有权Each item of Plant and Materials shall, to the extent consistent with the Laws of the Country, become the property of the Employer at whichever is the earlier of the following times, free from liens and other encumbrances:(a) when it is delivered to the Site;(b) when the Contractor is entitled to payment of the value of the Plant and Materials under Sub-Clause 8.10 [Payment for Plant and Materials in Event of Suspension].从下列二者中较早的时间起,在符合工程所在国法律规定范围内,每项生产设备和材料都应无扣押和其他阻碍的成为雇主的财产.当上述生产设备、材料运至现场时;当根据第8.10款[暂停时对生产设备和材料的支付]的规定,承包商有权得到按生产设备和材料价值的付款时.7.8 Royalties土地(矿区)使用费Unless otherwise stated in the Employer’s Requirements, the Contractor shall pay all royalties, rents and other payments for:(a) natural Materials obtained from outside the Site, and(b) the disposal of material from demolitions and excavations and of other surplus material (whether natural or man-made), except to the extent that disposal areas within the Site are specified in the Contract.除非在雇主要求中另有说明,承包商应为以下事项支付所有的土地(矿区)使用费、租金和其他付款:从现场以外地区得到的天然材料;在合同规定的现场范围内的弃置区以外,弃置拆除、开挖的材料和其他剩余材料(不论是天然的或人工的).8.1 Commencement of Works工程的开工Unless otherwise stated in the Contract Agreement:(a) the Employer shall give the Contractor no t less than 7 days’ notice of the Commencement Date; and(b) the Commencement Date shall be within 42 days after the date on which the Contract comes into full force and effect under Sub-Clause 1.6 [Contract Agreement].The Contractor shall commence the design and execution of the Works as soon as is reasonably practicable after the Commencement Date, and shall then proceed with the Works with due expedition and without delay.除非合同协议书另有说明:雇主应在不少于7天前向承包商发出开工日期的通知;开工日期应在第1.6款[合同协议书]规定的合同全面实施和生效日期后42天内.承包商应在开工日期后,在合理可能情况下尽早开始工程的设计和施工,随后应以正当速度,不拖延地进行工程.8.2 Time for Completion竣工时间The Contractor shall complete the whole of the Works, and each Section (if any), within the Time for Completion for the Works or Section (as the case may be), including:(a) achieving the passing of the Tests on Completion, and(b) completing all work which is stated in the Contract as being required for the Works or Section to be considered to be completed for the purposes of taking-over under Sub-Clause 10.1 [Taking Over of the Works and Sections].承包商应在工程或分项工程(视情况而定)的竣工时间内,完成整个工程和每个分项工程(如果有),包括:竣工试验获得通过;完成合同提出的、工程和分项工程按照第10.1款[工程和分项工程的接收]规定的接收要求竣工所需要的全部工作.8.3 Programme进度计划The Contractor shall submit a time programme to the Employer within 28 days after the Commencement Date. The Contractor shall also submit a revised programme whenever the previous programme is inconsistent with actual progress or with the Contractor’s obligations. Unless otherwise stated in the Contract, each programme shall include:(a) the order in which the Contractor intends to carry out the Works, including the anticipated timing of each major stage of the Works,(b) the periods for reviews under Sub-Clause 5.2 [Contractor’s Documents],(c) the sequence and timing of inspections and tests specified in the Contract, and(d) a supporting report which includes:(i) a general description of the methods which the Contractor intends to adopt for the execution of each major stage of the Works, and(ii) the approximate numb er of each class of Contractor’s Personnel and of each type of Contractor’s Equipment for each major stage.承包商应在开工日期后28天内,向雇主提交一份进度计划.当原定进度计划与实际进度或承包商的义务不相符时,承包商还应提交一份修订的进度计划.除非合同另有说明,每份进度计划应包括:承包商计划实施工程的工作顺序,包括工程各主要阶段的预期时间安排;根据第5.2款[承包商文件]规定的审核期限;合同中规定的各项检验和试验的顺序的顺序和时间安排;一份支持报告,内容包括:承包商在工程各主要阶段的实施中拟采用的方法的一般描述;各主要阶段配备的各级承包商人员和各类型承包商设备的大概数量.Unless the Employer, within 21 days receiving a programme, gives notice to the Contractor stating the extent to which it does not comply with the Contract, the Contractor shall proceed in accordance with the programme, subject to his other obligations under the Contract. The Employer’s Personnel shall be entitled to rely upon the programme when planning their activities.除非雇主在收到进度计划后21天内向承包商发出通知,指出其中不符合合同要求的部分,承包商即按照该进度计划,并遵守合同规定的其它义务,进行工作.雇主人员应有权依照该进度计划安排他们的活动.The Contractor shall promptly give notice to the Employer of specific probable future events orcircumstances which may adversely affect or delay the execution of the Works. In this event, or if the Employer gives notice to the Contractor that a programme fails (to the extent stated) to comply with the Contract or to be consistent with actual progress and the Contractor’s stated intentions, the Contractor shall submit a revised programme to the Employer in accordance with this Sub-Clause.承包商应及时将未来可能对工程施工造成不利影响或延误的事件或情况通知雇主.在此情况下,或在雇主通知承包商指出进度计划(在指出的部分)不符合合同要求,或与实际进度或承包商提出的意向不一致时,承包商应遵照本款要求向雇主提交一份修订进度计划.8.4 Extension of Time for Completion竣工时间延长The Contractor shall be entitled subject to Sub-Clause 20.1 [Contractor’ Claims] to an extensi on of the Time for Completion if and to the extent that completion for the purposesof Sub-Clause 10.1 [Taking Over of the Works and Sections] is or will be delayed by any of the following causes:(a) a Variation (unless an adjustment to the Time for Completion has been agreed under Sub-Clause 13.3 [Variation Procedure]),(b) a cause of delay giving an entitlement to extension of time under a Sub-Clause of these Conditions, or(c) any delay, impediment or prevention caused by or attributable to the Employer, the Employer’s Personnel, or the Employer’s other contractors on the Site.如由于下列任何原因,致使达到按照第10.1款[工程和分项工程的接收]要求的竣工受到或将受到延误的程度,承包商有权按照第20.1款[承包商的索赔]的规定提出延长竣工时间:变更(除非已根据第13.3款[变更程序]的规定商定调整了竣工时间);根据本条件某款,有权获得延长期的原因;或由雇主、雇主人员、或在现场的雇主的其他承包商造成或引起的任何延误、妨碍和阻碍.If the Contractor considers himself to be entitled to an extension of the Time for Completion, the Contractor shall give notice to the Employer in accordance with Sub-Clause 20.1 [Contractor’s Claims]. When determining each extension of time under Sub-Clause 20.1, the Employer shall review previous determinations and may increase, but shall not decrease, the total extension of time.如果承包商认为他有权提出延长竣工时间,应按照第20.1款[承包商的索赔]的规定,向雇主发出通知.雇主每次按照第20.1款确定延长时间时,应对以前所作的确定进行审核,可以增加,但不得减少总的延长时间.8.5 Delays Caused by Authorities当局造成的延误If the following conditions apply, namely:(a) the Contractor has diligently followed the procedures laid down by the relevant legally constituted public authorities in the Country,(b) these authorities delay or disrupt the Contractor’s work, and(c) the delay or disruption was not reasonably foreseeable by an experienced contractor by the date for submission of the Tender,then this delay or disruption will be considered as a cause of delay under sub-paragraph (b) of Sub-Clause 8.4 [Extension of Time for Completion].如果符合下列条件,即:承包商已努力遵守了工程所在国依法成立的有关公共当局所制定的程序;这些当局延误或打乱了承包商的工作;延误或中废是一个有经验的承包商在递交投标书时无法合理预见的;则上述延误或中断应被视为根据第8.4款[竣工时间的延长](b)项规定的延误的原因.8.6 Rate of Progress工程进度If, at any time:(a) actual progress is too slow to complete within the Time for Completion, and/or(b) progress has fallen (or will fall) behind the current programme under Sub-Clause 8.3 [Programme],如果在任何时候:实际工程进度对于在竣工时间内完工过于迟缓,和(或)进度已(或将)落后于根据第8.3款[进度计划]的规定制订的现行进度计划,other than as a result of a cause listed in Sub-Clause 8.4[Extension of Time for Completion], then the Employer may instruct the Contractor to submit, under Sub-Clause 8.3 [Programme], a revised programme and supporting report describing the revised methods which the Contractor proposes to adopt in order to expedite progress and complete within the Time for Completion.除由于第8.4款[竣工时间的延长]中列举的某项原因造成的结果外,雇主可指示承包商根据第8.3款[进度计划]的规定提交一份修订的进度计划,以及说明承包商为加快进度在竣工时间内竣工,建议采取的修订方法的补充报告.Unless the Employer notifies otherwise, the Contractor shall adopt these revised methods, which may require increases in the working hours and/or in t he numbers of Contractor’s Personnel and/or Goods, at the risk and cost of the Contractor. If these revised methods cause the Employer to incur additional costs, the Contractor shall subject to Sub-Clause 2.5 [Employer’s Claims] pay these costs to the Employer, in addition to delay damages (if any) under Sub-Clause 8.7 below.除非雇主另有通知,承包商应采取这些修订方法,对可能需要增加工时、和(或)承包商人员和(或)货物的数量,承包商应自行承担风险和费用.如果这些修订方法使雇主招致附加费用,承包商应根据第2.5款[雇主的索赔]的要求,连同下述第8.7款中提出的误期损害赔偿费(如果有),向雇主支付这些费用.8.7 Delay Damages误期损害赔偿费If the Contractor fails to comply with Sub-Clause 8.2 [Time for Completion], the Contractor shall subject to Sub-Clause 2.5 [Employer’s Claims] pay delay damages to the Employer for this default. These delay damages shall be the sum stated in the Particular Conditions, which shall be paid for every day which shall elapse between the relevant Time for Completion and thedate stated in the Taking-Over Certificate. However, the total amount due under this Sub-Clause shall not exceed the maximum amount of delay damages (if any) stated in the Particular Conditions.如果承包商未能遵守第8.2款[竣工时间]的要求,承包商应当为其违约行为,根据第2.5款[雇主的索赔]的要求向雇主支付误期损害赔偿费.此项误期损害赔偿费应按照专用条件中规定的每天应付金额,以接收证书上注明的日期超过相应的竣工时间的天数计算.但按本款计算的赔偿总额,不得超过专用条件中规定的误期损害赔偿费的最高限额(如果有).These delay damages shall be the only damages due from the Contractor for such default, other than in the event of termination under Sub-Clause 15.2 [Termination by Employer] prior to completion of the Works, These damages shall not relieve the Contractor from his obligation to complete the works,or from any other duties, obligations or responsibilities which he may have under the Contract.除在工程竣工前根据第15.2款[由雇主终止]的规定终止的情况外,这些误期损害赔偿费应是承包商为此类违约应付的唯一损害赔偿费.这些损害赔偿费不应解除承包商完成工程的义务,或合同规定的其可能承担的其他责任、义务或职责.8.8 Suspension of Work暂时停工The Employer may at any time instruct the Contractor to suspend progress of part or all of the Works. During such suspension, the Contractor shall protect, store and secure such part or the Works against any deterioration, loss or damage.雇主可以随时指示承包商暂停工程某一部分或全部的施工.在暂停期间,承包商应保护、保管、并保证该部分或全部工程不致产生任何变质、损失或损害.The Employer may also notify the cause for the suspension. If and to the extent that the cause is notified and is theresponsibility of the Contractor, the following Sub-Clauses 8.9, 8.10 and 8.11 shall not apply.雇主还可以通知暂停的原因.如果是已通知了原因,而且是由于承包商的职责造成的情况,则下列第8.9、8.10和8.11款应不适用.8.9 Consequences of Suspension暂停的后果If t he Contractor suffers delay and/or incurs Cost from complying with the Employer’s instructions under Sub-Clause 8.8 [Suspension of Work] and/or from resuming the work, the Contractor shall give notice to the Employer and shall be entitled subject to Sub-Clause 20.1 [Contractor’s Claims] to:(a) an extension of time for any such delay, if completion is or will be delayed, under Sub-Clause 8.4 [Extension of Time for Completion], and(b) payment of any such Cost, which shall be added to the Contract Price.如果承包商因执行雇主根据第8.8款[暂时停工]的规定发出的指示,和(或)因为复工,而遭受延误和(或)招致增加费用,承包商应向雇主发出通知,并有权依照第20.1款[承包商的索赔]的规定提出:根据第8.4款[竣工时间的延长]的规定,如竣工已或将受到延误,应对任何此类延误给予延长期;对任何此类费用应加入合同价格,给予支付.After receiving this notice, the Employer shall proceed in accordance with Sub-Clause 3.5 [Determinations] to agree or determine these matters.雇主收到此通知后,应按照第3.5款[确定]的要求,对这些事项进行商定或确定.The Contractor shall not be entitled to an extension of time for, or to payment of the Cost incurred in, making good the consequences of the Contr actor’s faulty design, workmanship or materials, or of the Contractor’s failure to protect, store orsecure in accordance with Sub-Clause 8.8 [Suspension of Work].承包商应无权得到为弥补因承包商有缺陷的设计、工艺或材料,或因承包商未能按照第8.8款[暂时停工]的规定保护、保管、或保证安全的后果,带来的延长期和招致费用的支付.8.10Payment for Plant and Materials in Event of Suspension 暂停时对生产设备和材料的付款The Contractor shall be entitled to payment of the value (as at the date of suspension) of Plant and/or Materials which have not been delivered to Site, if:(a) the work on Plant or delivery of Plant and/or Materials has been suspended for more than 28 days, and(b) the Contractor has marked the Plant and/or Materials as the Employer’s property in accordance with the Employer’s instructions.在下列条件下,承包商有权得到尚未运到现场的生产设备和(或)材料(按暂停开始日期时)的价值的付款:生产设备的生产、或生产设备和(或)材料的交付被暂停达到28天以上;承包商已按雇主的指示,标明上述生产设备和(或)材料为雇主的财产.8.11 Prolonged Suspension 拖长的暂停If the suspension under Sub-Clause 8.8 [Suspension of Work] has continued for more than 84 days, the Contractor may request th e Employer’s permission to proceed. If the Employer does not give permission within 28 days after being requested to do so, the Contractor may, by giving notice to the Employer, treat the suspension as an omission under Clause 13 [Variations and Adjustments] of the affected part of the Works. If the suspension affects the whole of the Works, the Contractor may give notice of termination under Sub-Clause 16.2 [Termination by Contractor].如果第8.8款[暂时停工]所述的暂停已持续84天以上,承包商可以要求雇主允许继续施工.如在提出这一要求后28天内,雇主没有给出许可,承包商可以通知雇主,将工程受暂停影响的部分视为根据第13条[变更和调整]规定的删减项目.若暂停影响到整个工程,承包商可以根据第16.2款[由承包商终止]的规定发出终止的通知.8.12 Resumption of Work复工After the permission or instruction to proceed is given, the Parties shall jointly examine the Works and the Plant and Materials affected by the suspension. The Contractor shall make good any deterioration or defect in or loss of the Works or Plant or Materials, which has occurred during the suspension.在发出继续施工的许可或指示后,双方应共同对受暂停影响的工程、生产设备和材料进行检查.承包商应负责恢复在暂停期间发生的工程或生产设备或材料的任何变质、缺陷或损失.9Tests on Completion竣工试验9.1 Contractor’s Obligations承包商的义务The Contractor shall carry out the Tests on Completion in accordance with this Clause and Sub-Clause 7.4 [Testing], after providing the documents in accordance with Sub-Clause 5.6 [As-Built Documents] and Sub-Clause 5.7 [Operation and Maintenance Manuals].承包商应按照第5.6款[竣工文件]和第5.7款操作和维修手册]的要求,提供各种文件后,按照本条和第7.4款[试验]的要求进行竣工试验.The Contractor shall give to the Employer not less than 21 days’ notice of the date after which the Contractor will be ready to carry out each of the Tests on Completion. Unless otherwise agreed, Tests on Completion shall be carried out within 14 days after this date, on such day or days as the Employer shall instruct.承包商应提前21天将他可以进行每项竣工试验的日期通知雇主.除非另有商定,竣工试验应在此通知日期后的14天内,在雇主指示的某日或某几日内进行.Unless otherwise stated in the Particular Conditions, the Tests on Completion shall be carried out in the following sequence:(a) pre-commissioning tests, which shall include the appropriate inspections and (“dry” or “cold”) functional tests to dem onstrate that each item of Plant can safely under-take the next stage, (b);(b) commissioning tests, which shall include the specified operational texts to demonstrate that the Works or Section can be operated safely and as specified, under all available operating conditions; and(c) trial operation, which shall demonstrate that the Works or Section perform reliably and in accordance with the Contract.除非在专用条件中另有说明,竣工试验应按照以下顺序进行:启动前试验,应包括适当的检验和(“干”或“冷”)性能试验,以证明每项生产设备能够安全地承受下一阶段(b)项试验;启动试验,应包括规定地操作试验,以证明工程或分项工程能够在所有可利用地操作条件下安全地操作.试运行,应证明工程或分项工程运行可靠,符合合同要求.During trial operation, when the Works are operating under stable conditions, the Contractor shall give notice to the Employer that the Works are ready for any other Tests on Completion, including performance tests to demonstrate whether the Works conform with criteria specified in the Employer’s Requirements and with the Performance Guarantees.在试运行期间,当工程正在稳定条件下运行时,承包商应通知雇主,告知工程已可以做任何其他竣工试验,包括各种性能试验,以证明工程是否符合雇主要求中规定地标准和履约保证.Trial operation shall not constitute a taking-over under Clause 10 [Employer’s Taking Over]. Unless otherwise stated in the Particular Conditions, any product produced by the Works during trial operation shall be the property of the Employer.试运行不应构成第10条[雇主的接收]规定的接收.除非专用条件中另有说明,工程在试运行期间生产的任何产品应属于雇主的财产.In considering the results of the Tests on Completion, appropriate allowances shall be made for the effect of any use of the Works by the Employer on the performance or other characteristics of the Works. As soon as the Works, or a Section, have passed each of the Tests on Completion described in sub-paragraph (a), (b) or (c), the Contractor shall submit a certified report of the results of these Tests to the Employer.在考虑竣工试验结果时,雇主应适当考虑到因雇主对工程的任何使用,对工程的性能或其他特性产生的影响.一旦工程或某分项工程通过了本款(a)、(b)或(c)项中的每项竣工试验,承包商应向雇主提供一份经证实的这些试验结果的报告.9.2 Delayed Tests延误的试验If the Tests on Completion are being unduly delayed by the Employer, Sub-Clause 7.4 [Testing] (fifth paragraph) and/or Sub-Clause 10.3 [Interference with Tests on Completion] shall be applicable.If the Tests on Completion are being unduly delayed by the Contractor, the Employer may by notice require the Contractor to carry out the Tests within 21 days after receiving the notice. The Contractor shall carry out the Tests on such day or days within that period as the Contractor may fix and of which he shall give notice to the Employer.如果雇主不当地延误竣工试验,雇主可通知承包商,要求在接到通知后21天内进行竣工试验.承包商应在上述期限内的某日或某几日内进行。

FIDIC条款中英文对照全文

FIDIC条款中英文对照全文

FOREWORD前言 (补充译文)The terms of the Fourth Edition of the Conditions of Contract for Works of Civil Engineering Construction have been prepared by the Fédération Internationale des Ingénieurs Conseils (FIDIC) and are recommended for general use for the purpose of construction of such works where tenders are invited on an intemational basis. The Conditions, subject to minor modifications, are also suitable for use on domestic contracts.土木工程施工合同条件的第四版已由国际咨询工程师联合会(以下简称为FIDIC)起草完成,并被推荐为以国际性招标为主的同类工程施工的通用条件,如果稍加修改,也适用于国内的招标合同。

The version in English of the Conditions is considered by FIDIC as the official and authentic text for the purpose of translation.本条件的英文版本, FIDIC已将其作为正式的和有效的语言文本,以用于翻译之目的。

In the preparation of the Conditions it was recognised that while there are numerous Clauses which will be generally applicable there are some Clauses which must necessarily vary to take account of the circumstances and locality of the Works. The Clauses of general application have been grouped together in this document and are referred to as Part I - General Conditions. They have been printed in a form which will facilitate their inclusion as printed in the contract documents normally prepared.在对本条件准备的过程中,发现多数条款是可以通用的,同时还考虑到工程所处的不同环境和地区须对某些条款加以必要的改动。

[新红皮书全文] FIDIC施工合同条件(完整WORD版)

[新红皮书全文] FIDIC施工合同条件(完整WORD版)

引言国际咨询工程师联合会(FIDIC)现于1999年出版下列四份新的合同标准格式的第一版:●施工合同条件(Conditions of Contract for Construction)推荐用于由雇主设计的、或由其代表—工程师设计的房屋建筑或工程(building or engineering works)。

在这种合同形式下,承包商一般都按照雇主提供的设计施工。

但工程中的某些土木、机械、电力和/或建造工程也可能由承包商设计。

●永久设备和设计—建造合同条件(Conditions of Contract for Plant and Design-Build)推荐用于电力和/或机械设备的提供,以及房屋建筑或工程的设计和实施。

在这种合同形式下,一般都是由承包商按照雇主的要求设计和提供设备和/或其它工程(可能包括由土木、机械、电力、和/或建造工程的任何组合形式)。

●EPC/交钥匙项目合同条件(Conditions of Contract for EPC/Turnkey Projects)适用于在交钥匙的基础上进行的工厂或其它类似设施的加工或能源设备的提供、或基础设施项目和其它类型的开发项目的实施,这种合同条件所适用的项目(i)对最终价格和施工时间的确定性要求较高,(ii)承包商完全负责项目的设计和施工,雇主基本不参与工作。

在交钥匙项目中,一般情况下由承包商实施所有的设计、采购和建造工作:即在“交钥匙”时,提供一个配备完整、可以运行的设施。

●合同的简短格式(Short Form of Contract)推荐用于价值相对较低的建筑或工程。

根据工程的类型和具体条件的不同,此格式也适用于价值较高的工程,特别是较简单的、或重复性的、或工期短的工程。

在这种合同形式下,一般都是由承包商按照雇主或其代表—工程师提供的设计实施工程,但对于部分或完全由承包商设计的土木、机械、电力、和/或建造工程的合同也同样适用。

建议在国际范围内招标时使用上述格式作为合同基础。

fidic2017版系列合同条件中英文

fidic2017版系列合同条件中英文

fidic2017版系列合同条件中英文全文共3篇示例,供读者参考篇1The FIDIC 2017 Suite of Contracts is widely recognized as the leading standard form of contracts for construction projects around the world. These contracts provide a comprehensive framework for managing the various risks and responsibilities involved in construction projects, and are used by contractors, employers, and engineers to establish clear and fair agreements.The FIDIC 2017 Suite of Contracts includes several different forms of contracts, each tailored to specific types of projects and project delivery mechanisms. These forms include the Red, Yellow, Silver, and Gold Books, as well as the Pink Book for dredging works, the Green Book for short-form contracts, and the White Book for client/consultant agreements.One of the key features of the FIDIC 2017 Suite of Contracts is the balanced allocation of risks between the parties involved in a construction project. The contracts are designed to ensure that each party bears the risks that they are best able to manage,while also providing mechanisms for addressing unforeseen events and changes in the scope of work.The FIDIC 2017 Suite of Contracts is also notable for its use of clear and concise language, which helps to reduce the potential for disputes and misunderstandings between the parties. The contracts provide detailed provisions for issues such as payment, variations, extensions of time, and claims, helping to ensure that all parties are aware of their rights and obligations.Overall, the FIDIC 2017 Suite of Contracts represents a significant step forward in the standardization and improvement of construction contracts. By providing a clear and fair framework for managing construction projects, these contracts help to promote successful outcomes for all parties involved.篇2FIDIC 2017 Edition Series Contracts: The Ultimate GuideIntroductionThe FIDIC (International Federation of Consulting Engineers) Contracts are a series of standard forms of contract published by FIDIC and widely used in the construction industry worldwide. The FIDIC 2017 Edition Series Contracts are the latest editions of these contracts and have been updated to reflect the currentindustry practices and trends. This ultimate guide will provide a comprehensive overview of the key features and changes in the FIDIC 2017 Edition Series Contracts.Overview of FIDIC 2017 Edition Series ContractsThe FIDIC 2017 Edition Series Contracts consist of the following contracts:- Red Book (Conditions of Contract for Construction)- Yellow Book (Conditions of Contract for Plant and Design-Build)- Silver Book (Conditions of Contract for EPC/Turnkey Projects)- Green Book (Short Form of Contract)- Blue Book (Client/Consultant Model Services Agreement)Changes and Updates in the FIDIC 2017 Edition Series ContractsThe FIDIC 2017 Edition Series Contracts introduce several key changes and updates, including:- Introduction of new provisions for dispute avoidance and resolution mechanisms- Clarification of the roles and responsibilities of the parties involved in the contract- Introduction of new provisions for the use of digital tools and technologies in the management of contracts- Inclusion of provisions for environmental and social sustainability considerations- Introduction of new payment mechanisms and provisions for the management of variations and claimsKey Features of the FIDIC 2017 Edition Series ContractsThe FIDIC 2017 Edition Series Contracts include a number of key features that make them unique and widely used in the construction industry. Some of the key features of these contracts include:- Standardized forms of contract that provide a clear and consistent framework for the management of construction projects- Balanced risk allocation between the parties involved in the contract- Provisions for flexibility and adaptability to suit the specific needs of different projects- Comprehensive set of provisions covering all aspects of the construction project lifecycle- Global recognition and acceptance by governments, international funding agencies, and industry stakeholdersConclusionThe FIDIC 2017 Edition Series Contracts are the latest editions of the FIDIC standard forms of contract and reflect the current industry practices and trends. These contracts provide a clear and consistent framework for the management of construction projects, with provisions for dispute avoidance and resolution mechanisms, roles and responsibilities of the parties, use of digital tools and technologies, and environmental and social sustainability considerations. The FIDIC 2017 Edition Series Contracts are widely used in the construction industry worldwide and are recognized for their balanced risk allocation, flexibility, and adaptability.篇3The FIDIC 2017 Suite of Contracts – An OverviewIntroductionThe FIDIC (International Federation of Consulting Engineers) 2017 Suite of Contracts is a series of standard forms of contract for the construction industry. These contracts are widely used globally and are considered to be the most comprehensive and reputable standard forms in the industry. The FIDIC 2017 Suite consists of seven different contracts, each tailored to meet the specific needs of different types of construction projects.Overview of the FIDIC 2017 Suite1. Conditions of Contract for Construction (Red Book)The Red Book is the most commonly used contract in the FIDIC 2017 Suite and is designed for use on large construction projects. It provides a detailed framework for the parties to manage the construction process, including the roles and responsibilities of each party, the procedures for making variations to the works, and the mechanisms for resolving disputes.2. Conditions of Contract for Plant and Design-Build (Yellow Book)The Yellow Book is specifically designed for projects where the contractor is responsible for both the design and construction of the works. It sets out the obligations of thecontractor in relation to the design and construction of the works, as well as the procedures for submitting and assessing designs.3. Conditions of Contract for EPC/Turnkey Projects (Silver Book)The Silver Book is intended for use on projects where the contractor is responsible for engineering, procurement, and construction. It provides a comprehensive framework for managing the project, including the requirements for completion and handover of the works.4. Short Form of Contract (Green Book)The Green Book is a simplified form of contract that is often used for smaller projects or projects with lower levels of risk. It is designed to be easy to understand and use, with fewer provisions and less complexity than the other contracts in the Suite.5. Conditions of Contract for Design-Build and Operate Projects (Gold Book)The Gold Book is intended for projects where the contractor is responsible for designing, building, and operating the works. It sets out the requirements for the design and construction of theworks, as well as the operation and maintenance of the works during the operation phase.6. Subcontract for Construction (Sub-Contract)The Sub-Contract is used on projects where the main contractor wishes to subcontract part of the works to another party. It provides a framework for the main contractor to engage a subcontractor and sets out the rights and obligations of both parties.7. Short Form of Subcontract (Green Subcontract)The Green Subcontract is a simplified form of subcontract that is often used for smaller or less complex subcontracts. It is designed to be easy to understand and use, with fewer provisions and less complexity than the main Sub-Contract.ConclusionThe FIDIC 2017 Suite of Contracts provides a comprehensive and internationally recognized framework for managing construction projects. Each contract in the Suite is tailored to meet the specific needs of different types of projects, from large construction projects to smaller subcontracts. By using the FIDIC 2017 Suite, parties can ensure that their contracts are clear, fair,and balanced, and that they have a reliable framework for managing the project from start to finish.。

FIDIC设计采购施工EPC合同条件英文版

FIDIC设计采购施工EPC合同条件英文版

FIDIC设计采购施工EPC合同条件英文版FIDIC DESIGN, PROCUREMENT AND CONSTRUCTION (EPC) CONTRACT CONDITIONS1. IntroductionThe FIDIC Design, Procurement and Construction (EPC) Contract Conditions serve as a comprehensive framework for the execution of construction projects using the Engineering, Procurement, and Construction (EPC) model. These conditions aim to establish a clear legal and contractual relationship between the employer and the contractor, ensuring a smooth and efficient project delivery.2. General Provisions2.1 PartiesThe contract shall be entered into between the employer and the contractor, where the employer represents the entity or organization procuring the construction services, and the contractor is responsible for the design, procurement, and construction activities.2.2 Scope of WorkThe contractor shall execute the works as described in the contract documents, including the design, procurement, construction, testing, and commissioning of the project. The scope of work shall be clearly defined and agreed upon by both parties.3. Contract Documents3.1 GeneralThe contract documents include all the agreements, specifications, drawings, and other relevant documents that form the basis of the contractual relationship. These documents shall be identified and attached as part of the contract, ensuring transparency and clarity.3.2 Engineer's RoleThe engineer shall act as an impartial party, responsible for administering the contract and ensuring compliance with the specifications and requirements. The engineer will issue instructions, determine variations, and certify the completion of works.4. Rights and Obligations4.1 Employer's Rights and ObligationsThe employer shall provide the contractor with access to the project site, necessary permits, and licenses. The employer shall also make timely payments and provide the necessary information to facilitate the execution of the works.4.2 Contractor's Rights and ObligationsThe contractor shall execute the works in accordance with the contract, comply with the specifications, and provide competent personnel and equipment. The contractor shall also ensure the safety and welfare of the project site and adhere to project schedules.5. Time for Completion and Liquidated Damages5.1 Time for CompletionThe contract specifies the agreed-upon time for completion, taking into account any extensions or modifications agreed upon by both parties. The contractor shall diligently execute the works within the stipulated timeframe.5.2 Liquidated DamagesIn the event of a delay in completion, the employer may impose liquidated damages as compensation for the loss suffered. The amount of liquidated damages shall be stated in the contract and serve as an agreed-upon pre-estimate of damages.6. Payments and Variations6.1 Payment TermsThe contractor shall submit interim payment applications based on the completed works and the approved rates. The employer shall make payments within the agreed-upon timeframe, subject to any applicable deductions or retentions.6.2 VariationsVariations may be instructed by the engineer, entailing additions, omissions, or alterations to the works. The contractor shall provide cost and time adjustments resulting from variations, and the engineer shall assess and certify these adjustments accordingly.7. Defects Liability Period7.1 Rectification of DefectsUpon completion of the works, a defects liability period shall be agreed upon. During this period, the contractor shall rectify any defects, damages, or deficiencies at their own cost and in a timely manner.7.2 Extension of Defects Liability PeriodIf new defects emerge during the defects liability period, the employer may extend the defects liability period to allow for their rectification. The contractor shall be notified in writing of any such extension.8. Dispute Resolution8.1 Amicable SettlementAny dispute arising under the contract shall initially be resolved amicably through negotiations between the parties. Both the employer and contractor shall make every effort to settle the dispute in good faith.8.2 ArbitrationIn the event that an amicable settlement cannot be reached, the dispute shall be referred to arbitration for resolution. The arbitration proceedings shall be conducted in accordance with the rules of the governing law and specified in the contract.9. Governing Law and LanguageThe contract shall be governed by the laws of the country and any specified legal jurisdiction. The official language shall be English unless otherwise agreed upon by the parties.10. ConclusionThe FIDIC Design, Procurement and Construction (EPC) Contract Conditions provide a robust framework for the execution of construction projects using the EPC model. These conditions outline the rights, obligations, and responsibilities of the employer and contractor, ensuring a fair and efficient project delivery. By adhering to these contract conditions, parties can mitigate risks, establish clear communication channels, and achieve successful project outcomes.。

FIDIC 条款中英文对照全文

FIDIC 条款中英文对照全文

Section IV. Part I. General Conditions of Contract 1 仅供内部使用和参考读前说明为了方便大家在工程上对国际咨询工程师联合会编写出版的《土木工程施工国际招标合同第一部分-通用条件》(以下简称FIDIC合同条件) 的使用,本人根据中国航空工业出版社出版发行的本条件的应用指南,已将其第四版发行的内容整理成英汉对照的电子版本。

正文里的条款按原文的两种语言对照录入,只在自己认为明显不妥的地方插入了自己的译法,同时对某些句子的措词和修饰也加进了一点改进意见(原文用红色标注,自己插入的译文和改动用蓝色标注)。

在此需要说明的是,插入的译文和对原译文的一些改动意见,旨在使原译文更接近于中文习惯及增加它的可读性,并不敢妄加更正,仅供对照原译文参考理解。

附录部分没有对应的译文,如:前言、索引、附件,1988年修订版说明和1992年再版修正说明等。

因此,对照英文内容为其增加了中文译文。

由于时间仓促和自己的知识面有限,在翻译和录入过程中难免会出现错误,希望各位领导和同事批评指正。

周彦松 2004年8月29日于金边FOREWORD前言 (补充译文)The terms of the Fourth Edition of the Conditions of Contract for Works ofCivil Engineering Construction have been prepared by the FédérationInternationale des Ingénieurs Conseils (FIDIC) and are recommended forgeneral use for the purpose of construction of such works where tenders areinvited on an intemational basis. The Conditions, subject to minormodifications, are also suitable for use on domestic contracts.土木工程施工合同条件的第四版已由国际咨询工程师联合会(以下简称为FIDIC)起草完成,并被推荐为以国际性招标为主的同类工程施工的通用条件,如果稍加修改,也适用于国内的招标合同。

fidic合同施工条件2017中英文

fidic合同施工条件2017中英文

fidic合同施工条件2017中英文The FIDIC Conditions of Contract for Construction 2017: A Comprehensive AnalysisThe FIDIC Conditions of Contract for Construction, also known as the "Red Book," is a widely recognized and extensively used set of standard contract conditions for construction projects worldwide. The 2017 edition of this document, released by the International Federation of Consulting Engineers (FIDIC), has introduced several significant changes and updates to the previous version, making it essential for industry professionals to understand and adapt to these new provisions.The FIDIC Conditions of Contract for Construction 2017 represent a comprehensive and well-structured framework that aims to establish a balanced and equitable relationship between the employer and the contractor. This document covers a wide range of contractual aspects, including the roles and responsibilities of the parties involved, the management of the construction process, the handling of claims and disputes, and the termination of the contract.One of the notable changes in the 2017 edition is the increasedemphasis on the role of the Engineer. The Engineer, who acts as the representative of the employer, is now granted more authority and decision-making power throughout the construction process. This includes the ability to issue instructions, approve variations, and make determinations on matters such as time extensions and the assessment of claims.Another significant update is the introduction of the "Employer's Requirements" concept, which replaces the previous "Employer's Drawings and Employer's Requirements" approach. This new approach requires the employer to provide a clear and comprehensive set of requirements, including performance specifications, design criteria, and any relevant employer-supplied information. This shift places a greater responsibility on the employer to ensure that the project's requirements are well-defined and communicated effectively to the contractor.The 2017 edition also places a stronger emphasis on the management of time-related issues. The contract now includes more detailed provisions for the assessment of time extensions, the handling of delays, and the calculation of delay damages. Additionally, the concept of "Contractor's Claims" has been expanded, providing the contractor with a more structured process for submitting and pursuing claims related to time and cost.The dispute resolution mechanism has also undergone changes in the 2017 edition. The contract now includes a three-tier dispute resolution process, starting with a Dispute Avoidance/Adjudication Board (DAAB), followed by amicable settlement, and finally, arbitration. This tiered approach aims to encourage the parties to resolve disputes at the earliest possible stage, reducing the need for formal arbitration proceedings.Furthermore, the 2017 edition introduces new provisions related to sustainability and environmental considerations. Contractors are now required to comply with applicable environmental laws and regulations, and the contract includes specific clauses addressing the management of environmental impacts and the implementation of sustainable practices.Overall, the FIDIC Conditions of Contract for Construction 2017 represent a significant evolution in the standard contract conditions for construction projects. The changes and updates introduced in this edition are designed to address the evolving needs of the construction industry, promote better risk allocation, and foster more collaborative and efficient project delivery. As such, it is essential for industry professionals, including employers, contractors, and consultants, to familiarize themselves with the nuances of this updated document to ensure successful project execution and management.。

FIDIC红皮书-施工合同条件__(中英文对照)

FIDIC红皮书-施工合同条件__(中英文对照)

Fédération Internationale Des Ingénieurs-Conseils(红皮书--施工合同条件)General Conditions1.一般规定General Provisions1.1 定义Definitions在包括专用条件和本通用条件的合同条件(“本合同条件”)中,以下措辞和用语的含义如下所述。

除非上下文中另有要求,指当事人和当事各方的词包括公司和其它法律实体。

In the Conditions of Contract ("these Conditions"), which include Particular Conditions and these General Conditions, the following words and expressions shall have the meanings stated. Words indicating persons or parties include corporations and other legal entities, except where the context requires otherwise.1.1.1 合同1.1.1 The Contract1.1.1.1“合同(Contract)”指合同协议书、中标函、投标函、本合同条件、规范、图纸、资料表、以及在合同协议书或中标函中列明的其它进一步的文件(如有时)。

1.1.1.1 "Contract" means the Contract Agreement, the Letter of Acceptance, the Letter of Tender, these Conditions, the Specification, the Drawings, the Schedules, and the further documents (if any) which are listed in the Contract Agreement or in the Letter of Acceptance.1.1.1.2“合同协议书(Contract Agreement)”指第1.6款【合同协议】中所说明的合同协议(如有时)。

(1999新红皮书中英文对照版)FIDIC土木工程施工合同条件

(1999新红皮书中英文对照版)FIDIC土木工程施工合同条件

Fédération Internationale Des Ingénieurs-Conseils通用条件General Conditions1.一般规定General Provisions1.1 定义Definitions在包括专用条件和本通用条件的合同条件(“本合同条件”)中,以下措辞和用语的含义如下所述。

除非上下文中另有要求,指当事人和当事各方的词包括公司和其它法律实体。

In the Conditions of Contract ("these Conditions"), which include Particular Conditions and these General Conditions, the following words and expressions shall have the meanings stated. Words indicating persons or parties include corporations and other legal entities, except where the context requires otherwise.1.1.1 合同1.1.1 The Contract1.1.1.1“合同(Contract)”指合同协议书、中标函、投标函、本合同条件、规范、图纸、资料表、以及在合同协议书或中标函中列明的其它进一步的文件(如有时)。

1.1.1.1 "Contract" means the Contract Agreement, the Letter of Acceptance, the Letter of Tender, these Conditions, the Specification, the Drawings, the Schedules, and the further documents (if any) which are listed in the Contract Agreement or in the Letter of Acceptance.1.1.1.2“合同协议书(Contract Agreement)”指第1.6款【合同协议】中所说明的合同协议(如有时)。

fidic红皮书英文版带批注

fidic红皮书英文版带批注

Conditions of Contract for Construction建筑施工合同条件For Building and Engineering Works Designed by theEmployer雇主负责设计的建筑和工程合同General Conditions一般条件1. General Provisions一般规定...................1.1 Definitions定义......................1.1.1 The Contract合同.......................1.1.2 Parties and Persons各方和人员(当事人和人员)1.1.3 Dates, Tests, Periods and Completion日期、试验、期限和竣工1.1.4 Money and Payments款项和付款1.1.5 Works and Goods工程和货物...................1.1.6 Other Definitions其他定义.................1.2 Interpretation解释.....................1.3 Communications信息交流.....................1.4 Law and Language法律和语言...................1.5 Priority of Documents文件优先次序..............1.6 Contract Agreement合同协议书..................1.7 Assignment权益转让..................1.8 Care and Supply of Documents文件的照管和提供(管理)....1.9 Delayed Drawings or Instructions延误的图纸或指示..........1.10 Employer’s Use of Contractor’s Documents雇主使用的承包商的文件...................................................................1.11 Contractor’s Use of Employer’s Documents承包商使用的雇主的文件.................................................................1.12 Confidential Details保密事项..................1.13 Compliance with Laws遵守法律....................1.14 Joint and Several Liability连带责任................2 The Employer雇主.........................2.1 Right of Access to the Site现场进入权利.............2.2 Permits, Licences or Approvals许可、执照或批准..........2.3 Employer’s Personnel雇主人员...................2.4 Empl oyer’s Financial Arrangements雇主资金的安排...........2.5 Employer’s Claims雇主的索赔.................3. The Engineer工程师......................3.1 Engineer’s Duties and Authority工程师的任务和权力......3.2 Delegation by the Engineer工程师的付托(授权)......3.3 Instructions of the Engineer工程师的指示............3.4 Replacement of the Engineer工程师的替换..............3.5 Determinations确定.......................4. The Contractor承包商....................4.1 Contractor’s General Obligations承包商的一般义务........4.2 Performance Security履约担保...................4.3 Contractor’s Representative承包商的代表............4.4 Subcontractors分承包商...................4.5 Assignment of Benefit of Subcontract分包商合同权益的转让....4.6 Co-operation合作......................4.7 Setting Out放线......................4.8 Safety Procedures安全程序..................4.13 Rights of Way and Facilities道路通行权和设施........4.14 Avoidance of Interference避免干扰.................4.15 Access Route进场通路....................4.16 Transport of Goods货物运输...................4.17 Contractor’s Equipment承包商设备...............4.18 Protection of the Environment环境保护.................4.19 Electricity, Water and Gas电、水和燃气.............4.20 Employer’s Equipment and Free-Issue Material雇主的设备和免费的材料...............................................................4.21 Progress Reports进度报告...................4.22 Security of the Site现场保安(安全).......4.23 Contractor’s Operations on Site承包商的现场作业(工作).....................................................................4.24 Fossils化石......................5. Nominated Subcontractors指定的分包商..............5.1 Definition of “nominated Subcontractor”5.2 Objection to Nomination指定的分承包商的定义反对指定..........................5.3 Payments to nominated Subcontractors指定分承包商的付款.......5.4 Evidence of Payments付款证据..................6. Staff and Labour员工(工作人员和劳务人员).....................................................................6.1 Engagement of Staff and Labour员工的雇佣..............6.2 Rates of Wages and Conditions of Labour工资的标准和劳动条件...6.3 Persons in the Service of Employer为雇主服务的人员........6.4 Labour Laws劳动法.....................6.5 Working Hours工作时间..................6.6 Facilities for Staff and Labour为员工提供的设施.....6.7 Health and Safety健康和安全...............6.8 Contractor’s Superintendence承包商的监督............6.9 Contractor’s Personnel承包商人员..............6.10 Records of Contractor’s Personnel and Equipment承包商人员和设备的纪录.............................................................6.11 Disorderly Conduct无序的行为...............7. Plant, Material and Workmanship生产设备、材料和工艺......7.1 Manner of Execution实施的方法................7.2 Samples样品.......................7.3 Inspection检验...................7.4 Testing试验.....................7.5 Rejection拒收....................7.6 Remedial Work修补工作(补救工作).......7.7 Ownership of Plant and Materials生产设备和材料的所有权..7.8 Royalties 土地(矿区)使用费........8 Commencement, Delays and Suspension开始、延误和暂停(延期、中止).....................................................................8.1 Commencement of Works工程的开工..................8.2 Time for Completion竣工时间.................8.3 Programme进度计划...................8.4 Extension of Time for Completion竣工时间的延长.........8.5 Delays Caused by Authorities当局造成的延误..........8.6 Rate of Progress工程进度................8.7 Delay Damages误期损害赔偿金(延期).....8.8 Suspension of Work暂时停工(工程中止).....8.11 Prolonged Suspension8.12 Resumption of Work复工(工程的重新的开始).......9 Tests on Completion竣工试验.....................9.1 Contractor’s Obligations承包商的义务..............9.2 Delayed Tests延误的试验...................9.3 Retesting重新试验....................9.4 Failure to Pass Tests on Completion未能通过竣工试验.........10 Employer’s Taking Over雇主的接收................10.1 Taking Over of the Works and Sections工程和分项工程的接收....10.2 Taking Over of Parts of the Works部分工程的接收..........10.3 Interference with Tests on Completion对竣工试验的干扰......10.4 Surfaces Requiring Reinstatement需要复原的地表..........11 Defects Liability缺陷责任...............11.1 Completion of Outstanding Work and Remedying Defects完成扫尾工作和修补缺陷.........................................................11.2 Cost of Remedying Defects修补缺陷的费用...........11.3 Extension of Defects Notification Period缺陷通知期限的延长..11.4 Failure to Remedy Defects未能修缺陷...............11.5 Removal of Defective Work移出有缺陷的工程.........11.6 Further Tests进一步试验..............11.7 Right of Access进入权..................11.8 Contractor to Search承包商调查..............11.9 Performance Certificate履约证书...............11.10 Unfulfilled Obligations未履行的义务.........11.11 Clearance of Site现场清理...............12. Measurement and Evaluation测量和估价...............12.1 Works to be Measured需测量的工程............12.2. Method of Measurement测量方法.................12.3 Evaluation估价..................12.4 Omissions删减....................13. Variation and Adjustments变更和调整............13.1 Right to Vary变更权.................13.2 Value Engineering价值工程................13.3 Variation Procedure变更程序...............13.4 Payment in Applicable Currencies以适用货币支付(可采用的支付的货币).......................................................13.5 Provisional Sums暂列金额(临时金额)...13.6 Daywork计日工作................13.7 Adjustment for Changes in Legislation因法律改变的调整....13.8 Adjustments for Changes in Cost因费用改变的调整.....14. Contract Price and Payment合同价格(价款)和支付.....................................................................14.1 The Contract Price合同价格(价款)......14.2 Advance Payment预付款..................14.3 Application for Interim Payment Certificates期中付款证书的申请(申请期中付款凭证)..............................................14.4 Schedule of Payments付款计划表(付款时间表).....................................................................14.5 Plant and Materials intended for the Works拟用于工程的生产设备和材料(预定用于工程的生产设备和材料).............................14.6 Issue of Interim Payment Certificates期中付款证书的颁发(颁发期中付款证明).................................................14.7 Payment付款....................14.8 Delayed Payment延误付款(延期付款)...14.9 Payment of Retention Money保留金的支付..........14.10 Statement at Completion竣工报表.............14.11 Application for Final Payment Certificate最终付款证书的申请(申请最终付款凭证)...............................................14.12 Discharge结清证明..............14.13 Issue of Final Payment Certificate最终付款证书的颁发(颁发最终付款证书)...............................................14.14 Cessation of Employer’s Liability雇主责任的终止...14.15 Currencies of Payment支付的货币...........15 Termination by Employer由雇主终止............15.1 Notice to Correct通知改正(改正通知).....................................................................15.2 Termination by Employer由雇主终止............15.3 Valuation of Date of Termination终止日期时的估价...15.4 Payment after Termination终止后的付款.........15.5 Employer’s Entitlement to Termination雇主终止的权利....由承包商暂停和终止(承包16.1 Contractor’s Entitlement to Suspend Work承包商暂停工程的权利..16.2 Termination by Contractor由承包商终止(由承包商决定的终止)...........................................................16.3 Cessation of Work and Removal of Contractor’s Equipment停止工作和承包商设备的撤离(工作停止和承包商设备的撤离)...................16.4 Payment on Termination终止时的付款..............17 Risk and Responsibility风险和职责(风险和责任)....17.1 Indemnities保障........................17.2 Contractor’s Care of the Works承包商对工程的照顾........17.3 Employer’s Risks雇主的风险..................17.4 Consequences of Employer’s Risks雇主风险的后果.............................18 Insurance18.1 General Requirements for Insurances有关保险的一般要求(保险的一般要求)...........................................................18.2 Insurance for Works and Contractor’s Equipment工程和承包商生产设备的保险...........................................................18.3 Insurance against Injury to Persons and Damage to Property人身伤害和财产损害的保险.................................................18.4 Insurance for Contractor’s Personnel承包商人员的保险........19 Force Majeure不可抗力....................19.1 Definition of Force Majeure不可抗力的定义..........19.2 Notice of Force Majeure不可抗力的通知...........19.3 Duty to Minimise Delay将延误减至最小的义务19.4 Consequences of Force Majeure不可抗力的后果19.5 Force Majeure Affecting Subcontractor不可抗力影响分承包商19.6 Optional Termination, Payment and Release自主选择终止、付款和解除19.7 Release from Performance under the Law根据法律解除履约20 Claim, Disputes and Arbitration索赔、争端和仲裁20.1 Contractor’s Claims承包商的索赔20.2 Appointment of the Dispute Adjudication Board争端裁决委员会的任命20.3 Failure to Agree Dispute Adjudication Board对争端裁决委员会未取得一致20.4 Obtaining Dispute Adjudication Board’s Deci sion取得争端裁决委员会的决定20.5 Amicable Settlement友好解决20.6 Arbitration仲裁20.7 Failure to Comply with Dispute Adjudication Board’s Decision未能遵守争端裁决委员会的决定20.8 Expiry of Dispute Adjudication Board’s Appointment争端裁决委员会任命期满APPENDIX 附录General conditions of dispute adjudication agreement 争端裁决协议书的一般条件Index of sub-clauses 条款索引1 General Provisions一般规定1.1 Definitions定义In the Conditions of Contract (“these Conditions”), which include Particular Conditions and these General Conditions, the following words and expressions shall have the meanings stated. Words indicating persons or parties include corporations and other legal entities, except where thec requires otherwise.在合同条件下(这些条件,“本条件”),包括特殊条件和一般条件,以下的文字和表达将采用这种规定的意思。

菲迪克合同中英文对照

菲迪克合同中英文对照

菲迪克合同中英文对照菲迪克合同中英文对照FIDIC(国际工程承包商协会)是一个制定建筑工程合同标准的非政府组织。

FIDIC合同模板被广泛应用于全球的工程承包领域。

在FIDIC合同中,双方可以清楚明确地规定合同中的条件,如工程质量、完成时间、支付方式等。

在此,我们将为您介绍FIDIC合同的中英文对照。

一、合同的定义和说明中文版:这份协议由、和(被称为丙方)订立,为在上述项目(指第2页的项目)上建造、完善和交付该项目。

协议的“规范条款”是协议一部分并与协议中的规定一样重要,合同规定了工程质量、完成时间、支付方式等,同时将对在合同期间发生的争议进行调解。

英文版:This Agreement made on , between of (referred to as the "Employer") and of (referred to as the "Contractor") provides for the design, execution, completion and maintenance of the Works in accordance with the Contract. The "General Conditions" forming part of this Agreement, are as important as the provisions of this Agreement, and define the quality of the Works, the time for completion and the manner of payments, and provide for the mediation of disputes arising from the Contract.二、工程完成时间中文版:2.1 工程应在三十六个月内完成并竣工并且通知业主验收。

[新红皮书全文] FIDIC施工合同条件(完整WORD版)

[新红皮书全文] FIDIC施工合同条件(完整WORD版)

引言国际咨询工程师联合会(FIDIC)现于1999年出版下列四份新的合同标准格式的第一版:●施工合同条件(Conditions of Contract for Construction)推荐用于由雇主设计的、或由其代表—工程师设计的房屋建筑或工程(building or engineering works)。

在这种合同形式下,承包商一般都按照雇主提供的设计施工。

但工程中的某些土木、机械、电力和/或建造工程也可能由承包商设计。

●永久设备和设计—建造合同条件(Conditions of Contract for Plant and Design-Build)推荐用于电力和/或机械设备的提供,以及房屋建筑或工程的设计和实施。

在这种合同形式下,一般都是由承包商按照雇主的要求设计和提供设备和/或其它工程(可能包括由土木、机械、电力、和/或建造工程的任何组合形式)。

●EPC/交钥匙项目合同条件(Conditions of Contract for EPC/Turnkey Projects)适用于在交钥匙的基础上进行的工厂或其它类似设施的加工或能源设备的提供、或基础设施项目和其它类型的开发项目的实施,这种合同条件所适用的项目(i)对最终价格和施工时间的确定性要求较高,(ii)承包商完全负责项目的设计和施工,雇主基本不参与工作。

在交钥匙项目中,一般情况下由承包商实施所有的设计、采购和建造工作:即在“交钥匙”时,提供一个配备完整、可以运行的设施。

●合同的简短格式(Short Form of Contract)推荐用于价值相对较低的建筑或工程。

根据工程的类型和具体条件的不同,此格式也适用于价值较高的工程,特别是较简单的、或重复性的、或工期短的工程。

在这种合同形式下,一般都是由承包商按照雇主或其代表—工程师提供的设计实施工程,但对于部分或完全由承包商设计的土木、机械、电力、和/或建造工程的合同也同样适用。

建议在国际范围内招标时使用上述格式作为合同基础。

fidic工程合同模板中英

fidic工程合同模板中英

fidic工程合同模板 中英这是小编精心编写的合同文档,其中清晰明确的阐述了合同的各项重要内容与条款,请基于您自己的需求,在此基础上再修改以得到最终合同版本,谢谢!标题:fidic工程合同模板(中英)一、前言本合同模板是根据国际咨询工程师联合会(FIDIC)的相关规定,结合我国实际情况,为工程建设项目量身定制的中英双语合同。

本合同旨在明确双方的权利、义务和责任,确保工程项目的顺利进行。

二、合同主体1. 承包商:(全称,以下简称“乙方”)2. 业主:(全称,以下简称“甲方”)三、合同条款1. 工程范围(1)乙方按照甲方提供的工程图纸、技术规范和施工要求,承担以下工程:1)土建工程;2)安装工程;3)调试工程;4)其他配套工程。

(2)乙方应按照合同约定的时间、质量、安全等要求,完成上述工程。

2. 合同价格(1)合同价格采用固定总价方式,包括但不限于设计、施工、材料、设备、劳务、管理、税费、利润等一切费用。

(2)合同价格的具体金额为:(大写:人民币 元整;小写:¥ 元)。

3. 工期(1)合同工期为(年/月/日)至(年/月/日),共计(天)。

(2)乙方应按照合同约定的工期完成工程,如因乙方原因造成工期延误,乙方应承担相应的违约责任。

4. 付款方式(1)合同签订后,甲方支付乙方合同总价款的(%)作为预付款。

(2)工程进度达到(%)时,甲方支付乙方合同总价款的(%)。

(3)工程竣工验收合格后,甲方支付乙方合同总价款的(%)。

(4)工程保修期满,甲方支付乙方合同总价款的(%)。

(5)剩余(%)的款项,按照双方约定的质量保证金返还方式进行支付。

5. 违约责任(1)如乙方未按照合同约定完成工程,应承担违约责任,向甲方支付违约金,违约金计算方式为:()。

(2)如甲方未按照合同约定支付款项,应承担违约责任,向乙方支付违约金,违约金计算方式为:()。

6. 争议解决(1)双方在履行合同过程中发生的争议,应首先通过友好协商解决。

FIDIC设计建造与交钥匙工程合同条件(中英文第2部分)

FIDIC设计建造与交钥匙工程合同条件(中英文第2部分)

Site Data现场数据4.9 The Employer shall have made available to the Contractor, prior to the Base Date, all the data on hydrological and sub-surface conditions at the Site, and studies on environmental impact, which have been obtained by or on behalf ofthe Employer from investigations for the Works. The Contractor shall be responsible for interpreting all data. The Contractor shall be deemed to have inspected and examined the Site, its surroundings, the above data and other available information, and to have satisfied himself (so far as is practicable, taking account of cost and time) before submitting the Tender, as to:(a) the form and nature of the Site, including the sub-surface conditions,(b) the hydrological and climatic conditions,(c) the extent and nature of the work and Materials necessary for the executionand completion of the Works, and the remedying of any defects, and(d) the means of access to the Site and the accommodation he may require. The Contractor shall be deemed to have obtained all necessary information as to risks, contingencies and all other circumstances which may influence or affect the Tender.在基准日期之前,雇主应向承包商提供由雇主或由雇主委托他人根据该项工程勘测所取得的现场水文及地表以下的数据,以及对环境影响的研究报告。

fidic生产设备和设计施工合同条件

fidic生产设备和设计施工合同条件

fidic生产设备和设计-施工合同条件篇一:FIDIC 生产设备和设计-施工合同条件2FIDIC CONDITIONS OF CONTRACT FOR PLANT AND DESIGN-BUILDINGFIDIC 生产设备和设计-施工合同条件(新黄皮书 1999)General Conditions通用条件CONTENTS1 1 GENERAL PROVISION. 一般规定Definitions定义Interpretation解释Communications通信交流Law and Language法律与语言Priority of Documents文件有效秩序Contract Agreement合同协议书Assignment权益转让Care and Supply of Documents文件的照管和提供Errors in the Employer’s Requirements雇主要求中的错误Employer’s Use of Contractor’s Documents雇主使用承包商的文件Contractor’s Use of Employer’s Documents承包商使用雇主的文件Confidential Details保密事项Compliance with Laws遵守法律Joint and Several Liability共同的和各自的责任2 THE EMPLOYER雇主Right of Access to the Site现场进入权Permits, Licenses or Approvals许可、执照或批准 Employer’s Personnel雇主人员Employer’s Financial Arrangements雇主的资金安排Employer’s Claims雇主的索赔3 THE ENGINEER工程师Engineer’s Duties and Authority工程师的任务和权力Delegation by the Engineer由工程师付托Instructions of the Engineer工程师的指示Replacement of the Engineer工程师的替换Determinations确定4 THE CONTRACTOR承包商Contractor’s General Obligations承包商的一般义务Performance Security履约担保Contractor’s Representative承包商代表Subcontractors分包商Nominated Subcontractors指定的分包商Co-operation合作Setting out放线Safety Procedures安全程序Quality Assurance质量保证Site Data现场数据Sufficiency of the Accepted Contract Amount中标合同金额的充分性Unforeseeable Physical Conditions不可预见的物质条件Rights of Way and Facilities道路通行权和设施Avoidance of Interference避免干扰Access Route进场通路Transport of Goods货物运输Contractor’s Equipment承包商设备Protection of the Environment环境保护Electricity, Water and Gas电、水和燃气Employer’s Equipment and Free-Issue Material雇主设备和免费提供的材料Progress Reports进度报告Security of the Site 现场安全Contractor’s Operations on Site承包商的现场作业Fossils化石5 DESIGN. 设计General Design Obligations设计义务一般要求Contractor’s Documents承包商文件Contractor’s undertaking承包商的承诺Technical Standards and Regulations技术标准和法规Training培训As-Built Documents竣工文件Operation and Maintenance Manuals操作和维修手册 Design Error设计错误6 STAFF AND LABOR员工Engagement of Staff and Labor员工的雇佣Rates of Wages and Conditions of Labor工资标准和劳动条件Persons in the Service of Employer为雇主服务的人员Labor Laws劳动法Working Hours工作时间Facilities for Staff and Labor为员工提供设施Health and Safety健康和安全Contractor’s Super intendance承包商的监督Contractor’s Personnel承包商人员Records of Contractor’s Personnel and Equipment 承包商人员和设备的记录Disorderly Conduct无序行为7 PLANT, MATERIALS AND WORKMANSHIP生产设备、材料和工艺Manner of Execution实施办法Samples样品Inspection检验Testing试验Rejection拒收Remedial Work修补工作Ownership of Plant and Materials生产设备和材料的所有权Royalties土地(矿区)使用费8COMMENCEMENT DELAYS AND SUSPENSION. 开工、延误和暂停Commencement of Work工程的开工Time for Completion竣工时间Programmed进度计划Extension of Time for Completion竣工时间的延长Delays Caused by Authorities当局造成的延误Rate of Progress工程进度Delay Damages误期损害赔偿费Suspension of Work暂时停工Consequences of Suspension暂停的后果Payment for Plant and Materials in Event of Suspension暂停时对生产设备和材料的付款Prolonged Suspension拖长的暂停Resumption of Work复工9 TESTS ON COMPLETION竣工试验Contractor’s Obligations承包商的义务Delayed Tests延误的试验Retesting重新试验Failure to Pass Tests on Completion未能通过竣工试验1 0Employer’s TAKING OVER雇主的接收Taking Over of the Works and Sections工程和单位工程的接收Taking Over of Parts of the Works部分工程的接收 Interference with Tests on Completion对竣工试验的干扰Surfaces Requiring Reinstatement需要复原的地面11 DEFECTS Liability. 缺陷责任Completion of Outstanding Work and Remedying Defects完成扫尾工作和修补缺陷 Cost of Remedying Defects修补缺陷的费用Extension of Defects Notification Period缺陷通知期限的延长Failure to Remedy Defects未能修补缺陷Removal of Defective Work移除有缺陷的工程Further Tests进一步试验Right of Access进入权Contractor to Search承包商调查Performance Certificate履约证书Unfulfilled Obligations未履行的义务Clearance of Site现场清理1 2 TESTS AFTER COMPLETION. 竣工后试验Procedure for Tests after Completion竣工后试验的程序Delayed Tests延误后的试验Retesting重新试验Failure to Pass Tests after Completion未能通过竣工后试验13 Variations AND ADJUSTMENTS变更和调整Right to Vary变更权Value Engineering价值工程Variation Procedure变更程序Payment in Applicable Currencies以适用货币支付Provisional Sums暂列金额Day work计日工作Adjustments for Changes in Legislation因法律改变的调整Adjustments for Changes in Cost因成本改变的调整14 CONTRACT PRICE AND PAYMENT合同价格和付款Contract Price合同价格Advance Payment预付款for Interim Pavement Certificates期中付款证书的申请Schedule of Payments付款计划表Plant and Materials intended for the Works拟用于工程的生产设备和材料 Issue of Interim Pavement Certificates期中付款证书的颁发Payment付款Delayed Payment延误的付款Payment of Retention Money保留金的支付Statement at Completion竣工报表Application for Final Payment Certificate最终付款证书的申请Discharge结清证明issue of Final Payment Certificate最终付款证书的颁发Cessation of Employer’s Liability雇主责任的终止Currencies of Payment支付的货币15 TERMINATIONS BY EMPLOYER由雇主终止Notice to Correct通知改正Termination by Employer由雇主终止Valuation at Date of Termination终止日期的估价 Payment after Termination终止后的付款Employer’s Entitlement to Termination雇主终止的权利16 SUSPENSE JON AND TERMINATION BY CONTRACTOR 由承包商暂停和终止 Contractor’s Entitlement to Suspend Work承包商暂停工作的权利Termination by Contractor由承包商终止Cessation of Work and Removal of Contractor’s 停止工作和承包商的撤离 Equipment 停止工作后的设备 Payment on Termination停止工作后的付款17 RISKS AND RESPONSIBILITY. 风险与职责Indemnities保障Contractor’s Care of the Works承包商对工程的照管Employer’s Risks雇主的风险Consequences of Employer’s Risks雇主风险的后果 Intellectual and Industrial Property Rights知识产权与工业产权Limitation of Liability责任限度18 INSURANCE保险General Requirements for Insurances有关保险的一般要求Insurance for Works and Contractor’s Equipment 工程和承包商设备的保险Insurance against Inquiry to Persons and Damage to Property人身伤害和财产损害险Insurance for Contractor’s Personnel 承包商人员的保险19 FORCE MAJEURE不可抗力Definition of Force Majuro不可抗力的定义Notice of Force Majuro不可抗力的通知Duty to Minimize Delay将延误减至最小的义务Consequences of Force Majuro不可抗力的后果Force Majuro Affecting Subcontractor不可抗力影响分包商Optional Termination, Payment and Release自主选择终止、付款和解除 Releases from Performance under the Law 根据法律解除履约20 CLAIMS, DISPUTES AND ARBITRATION. 索赔、争端和仲裁Contractor’s Claims承包商的索赔Appointment of the Dispute Adjudication Board争端裁决委员会的任命Failure to Agree Dispute Adjudication Board对争端裁决委员会未能取得一致Obtaining Dispute Adjudication Board’s Decision取得争端裁决委员会的决定 Amicable Settlement友好解决Arbitration仲裁Failure to Comply with Dispute Adjudication Board’s Decision未能遵守争端裁决委员会的决定 Expiry of Dispute Adjudication Board’s Appointment争端裁决委员会期满APPENDIX附录:篇二:FIDIC《生产设备和设计一施工合同条件》概述FIDIC《生产设备和设计一施工合同条件》概述FIDIC《生产设备和设计一施工合同条件》概述第六部分 FIDIC和世界银行编制的相关合同条件第一节 FIDIC《生产设备和设计-施工合同条件》一、FIDIC《生产设备和设计一施工合同条件》概述FIDIC于1999年出版了四本新的合同标准格式第一版,其中的《生产设备和设计一施工合同条件》(以下简称新黄皮书)推荐适用于电气和(或)机械设备供货以及建筑或工程的设计和施工。

  1. 1、下载文档前请自行甄别文档内容的完整性,平台不提供额外的编辑、内容补充、找答案等附加服务。
  2. 2、"仅部分预览"的文档,不可在线预览部分如存在完整性等问题,可反馈申请退款(可完整预览的文档不适用该条件!)。
  3. 3、如文档侵犯您的权益,请联系客服反馈,我们会尽快为您处理(人工客服工作时间:9:00-18:30)。

fidic施工合同条件中英文篇一:FIDIC土木工程施工合同条件(红皮书)_中英文通用条件General Conditions1 一般规定1. General Provisions定义Definitions在包括专用条件和本通用条件的合同条件(“本合同条件”)中,以下措辞和用语的含义如下所述。

除非上下文中另有要求,指当事人和当事各方的词包括公司和其它法律实体。

In the Conditions of Contract ("these Conditions"), which include Particular Conditions and these General Conditions, the following words and expressions shall have the meanings stated. Words indicating persons or parties include corporations and other legal entities, except where the context requires otherwise.合同The Contract“合同(Contract)”指合同协议书、中标函、投标函、本合同条件、规范、图纸、资料表、以及在合同协议书或中标函中列明的其它进一步的文件(如有时)。

"Contract" means the Contract Agreement, the Letter of Acceptance, the Letter of Tender, these Conditions, the Specification, the Drawings, the Schedules, and the further documents (if any) which are listed in the Contract Agreement or in the Letter of Acceptance.“合同协议书(Contract Agreement)”指第款【合同协议】中所说明的合同协议(如有时)。

"Contract Agreement" means the contract agreement (if any) referred to in Sub-Clause [Contract Agreement].“中标函(Letter of Acceptance)”指雇主对投标文件签署的正式接受函,包括其后所附的备忘录(由合同各方达成并签定的协议构成)。

在没有此中标函的情况下,“中标函”一词就指合同协议书,颁发或接收中标函的日期就指双方签订合同协议书的日期。

"Letter of Acceptance" means the letter of formal acceptance, signed by the Employer, of the Letter of Tender, including any annexed memoranda comprising agreements between and signed by both Parties. If there is no such letter of acceptance, the expression "Letterof Acceptance" means the Contract Agreement and the date of issuing or receiving the Letter of Acceptance means the date of signing the Contract Agreement.“投标函(Letter of Tender)”指名称为投标函的文件,由承包商填写,包括已签字的对雇主的工程报价。

"Letter of Tender" means the document entitled letter of tender, which was completed by the Contractor and includes the signed offer to the Employer for the Works.“规范(Specification)”指合同中名称为规范的文件,及根据合同规定对规范的增加和修改。

此文件具体描述了工程。

"Specification" means the document entitled specification, as included in theContract, and any additions and modifications to the specification in accordance with the Contract. Such document specifies the Works.“图纸(Drawings)”指合同中规定的工程图纸,及由雇主(或代表)根据合同颁发的对图纸的增加和修改。

"Drawings" means the drawings of the Works, as included in the Contract, and any additional and modified drawings issued by (or on behalf of, theEmployer in accordance with the Contract.“资料表(Schedules)”指合同中名称为资料表的文件,由承包商填写并随投标函提交。

此文件可能包括工程量表、数据、列表、及费率和/或单价表。

"Schedules" means the document(s) entitled schedules, completed by the Contractor and submitted with the Letter of Tender, as included in the Contract. Such document may include the Bill of Quantities, data, lists, and schedules of rates and/or prices “投标文件(Tender)”指投标函和合同中规定的承包商应随投标函提交的其它所有文件。

"Tender" means the Letter of Tender and all other documents which the Contractor submitted with the Letter of Tender, as included in the Contract.“投标函附录(Appendix to Tender)”指名称为投标函附录并已填写完毕的文件,附于投标函之后并构成投标函的一部分。

"Appendix to Tender" means the completed pages entitled appendix to tender which are appended to and form part of the Letter of Tender.“工程量表(Bill of Quantities)”和“计日工计划(Daywork Schedule)”指资料表中如此命名的文件(如有时)。

"Bill of Quantities" and "Day work Schedule" mean the documents so named (if any) which are comprised in the Schedules.当事各方和当事人and Persons“一方(Party)”指雇主或承包商(根据上下文而定)。

"Party" means the Employer or the Contractor, as the context requires.“雇主(Employer)”指在投标函附录中指定为雇主的当事人或此当事人的合法继承人。

"Employer" means the person named as employer in the Appendix to Tender and the legal successors in title to this person.“承包商(Contractor)”指在雇主收到的投标函中指明为承包商的当事人(一个或多个)及其合法继承人。

"Contractor" means the person(s) named as contractor in the Letter of Tender accepted by the Employer and the legal successors in title to this person(s).“工程师(Engineer)”指雇主为合同之目的指定作为工程师工作并在投标函附录中指明的人员,或由雇主按照第款【工程师的撤换】随时指定并通知承包商的其他人员。

"Engineer" means the person appointed by the Employer to act as the Engineer for the purposes of the Contract and named in the Appendix to Tender, or other person appointed from time to time by the Employer and noted to the Contractor under Sub-Clause [Replacement of the Engineer].“承包商的代表(Contractor’s Representitive)”指承包商在合同中指定的或由承包商按照第款【承包商的代表】随时指定的代表承包商的人员。

"Contractor's Representative" means the person named by the Contractor in the Contract or appointed from time to time by the Contractor under Sub-Clause [Contractor's Representative], who acts on behalf of the Contractor.“雇主的人员”指工程师,第款【工程师的授权】中所指的工程师助理以及所有其他职员、劳工和工程师或雇主的其他雇员;以及所有其他由雇主或工程师作为雇主的人员通知给承包商的人员。
