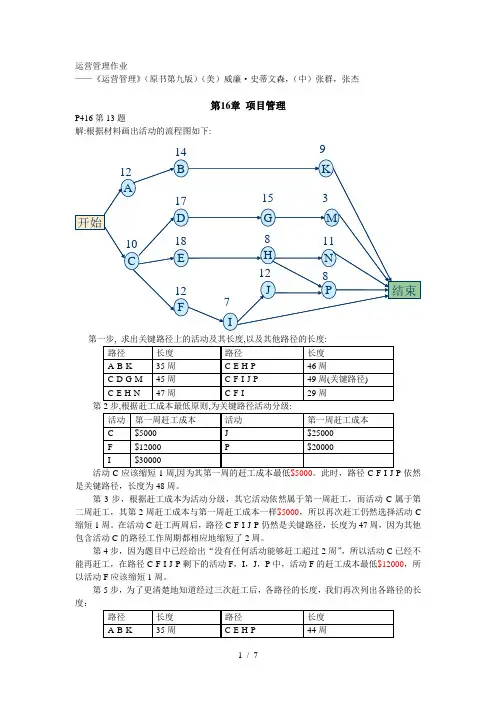

运营管理作业 ——《运营管理》(原书第九版)(美)威廉·史蒂文森,(中)张群,张杰第16章 项目管理P416第13题解:根据材料画出活动的流程图如下:9第2步,根据赶工成本最低原则,为关键路径活动分级:依然是关键路径,长度为48周。

第3步,根据赶工成本为活动分级,其它活动依然属于第一周赶工,而活动C 属于第二周赶工,其第2周赶工成本与第一周赶工成本一样$5000,所以再次赶工仍然选择活动C 缩短1周。

在活动C 赶工两周后,路径C-F-I-J-P 仍然是关键路径,长度为47周,因为其他包含活动C 的路径工作周期都相应地缩短了2周。

第4步,因为题目中已经给出“没有任何活动能够赶工超过2周”,所以活动C 已经不能再赶工,在路径C-F-I-J-P 剩下的活动F ,I ,J ,P 中,活动F 的赶工成本最低$12000,所以活动F 应该缩短1周。

第5步,为了更清楚地知道经过三次赶工后,各路径的长度,我们再次列出各路径的长度:由上表可见,经过三次赶工后,路径C-F-I-J-P仍然是关系路径,长度为46周,活动F 的第二周赶工成本为$15000,比剩下的活动I,J,P的第一周赶工成本更低,所以第四次赶工继续缩短活动F的加工时间1周。

接下来,路径C-E-H-N和路径C-F-I-J-P的长度都是45周,因此它们都是关键的。

第6步,在两条关键路径上根据赶工成本最低原则为活动分级(注意剔除已经不能再赶工的活动):的P,第五次赶工成本为$16000+$20000=$36000。

因此,成本最小的项目缩短5周的赶工进度安排是:活动C缩短2周;活动F缩短2周,活动E和活动P各缩短1周,总的赶工成本为2×$5000+2×$12000+$16000+$20000=$70000。
